The first Heritage build, documented.

5855 Oakridge Trail S · Afton MN 55001

Week by week.

Journal entries

  1. The front of the house at Oakridge in November, with the stucco finished and the scaffolding down.
    Week 30

    Stucco

    The first coat of stucco on the front of the house is finished, and the scaffolding is finally down. The final coat will wait until spring to have the best results and finish off this incredible house.

  2. Evergreens, ornamental grasses and shrubs waiting to be planted along the side of the house at Oakridge, November.
    Week 30

    Landscaping

    Landscaping has started. The beds along the house are getting a lot of evergreens and ornamental grasses, so they'll still look good in a Minnesota winter.

  3. The back of the house at Oakridge from the air at the end of October, with the valley behind it.
    Week 29

    Exterior

    The roof is finished, and most of the siding is on. We used impact-rated shingles on this house. They cost more than standard shingles, but they hold up much better in hail.

  4. The new fireplace at Oakridge, still in its protective cover, September.
    Week 23

    Fireplace

    The Urbana fireplace is in, and it's one of our favorite things in this house. The outside stays cool enough that wood or wallpaper can go right up around it, so the surround can be almost anything.

  5. A hallway at Oakridge with new drywall and an arched opening, mid-September.
    Week 23

    Drywall

    By the third week of September, drywall was hung in the living spaces and hallways. The crew was taping the seams and applying joint compound. The hallways include arched openings. A few walls were still open to the framing and insulation.

  6. The new double entry doors at Oakridge, set in the house wrap in early September.
    Week 21

    Entry doors and siding

    As summer wound down, the front entry doors were installed. Siding installation had started on the exterior walls. Siding color samples were on site for the final selections. A tractor was working the ground near the house.

  7. A gable at Oakridge with house wrap and roofing complete, photographed in August.
    Week 17

    House wrap and roofing

    By early August, house wrap covered the exterior walls and the roof was shingled. The house is protected from the weather, and work moves to the interior.

  8. An installed window at Oakridge, seen from inside the enclosed house.
    Week 15

    Windows and sheathing

    In the last week of July, the exterior walls were sheathed and the windows were installed. Roof underlayment was in place over the sheathing. The interior of the house is now enclosed.

  9. Wall framing and roof trusses at Oakridge in July.
    Week 13

    Roof trusses

    The roof trusses were set by mid-July. With the trusses in place, the full height and roof shape of the house are visible for the first time. Sheathing of the walls and roof follows.

  10. New wall framing at Oakridge on the concrete slab in early July.
    Week 12

    Wall framing

    Wall framing was underway by the Fourth of July. The exterior walls and the main interior walls were standing on the slab. Door and window openings were framed at their final locations.

  11. The poured concrete slab at Oakridge in June, with the safe room in the background.
    Week 10

    Concrete slab

    The concrete slab was poured before the end of June. The lines set during under-slab preparation now extend up through the floor at their planned locations. Wall framing begins next.

  12. Gravel base inside the Oakridge foundation, with plumbing lines in place and the concrete safe room at the center.
    Week 8

    Under-slab preparation

    In the first week of June, the crew finished preparing the base for the concrete floor. A layer of gravel was spread and leveled across the full footprint. Foam insulation was installed along the inside of the foundation walls. Plumbing lines were set in place before the pour. The walls of the concrete safe room were also complete.

  13. The completed Oakridge foundation, backfilled and leveled, with woods surrounding the site.
    Week 6

    Foundation complete

    The foundation was complete by Memorial Day. Soil was backfilled around the exterior walls, and the area inside the walls was filled and leveled. The next stage is preparation for the concrete floor.

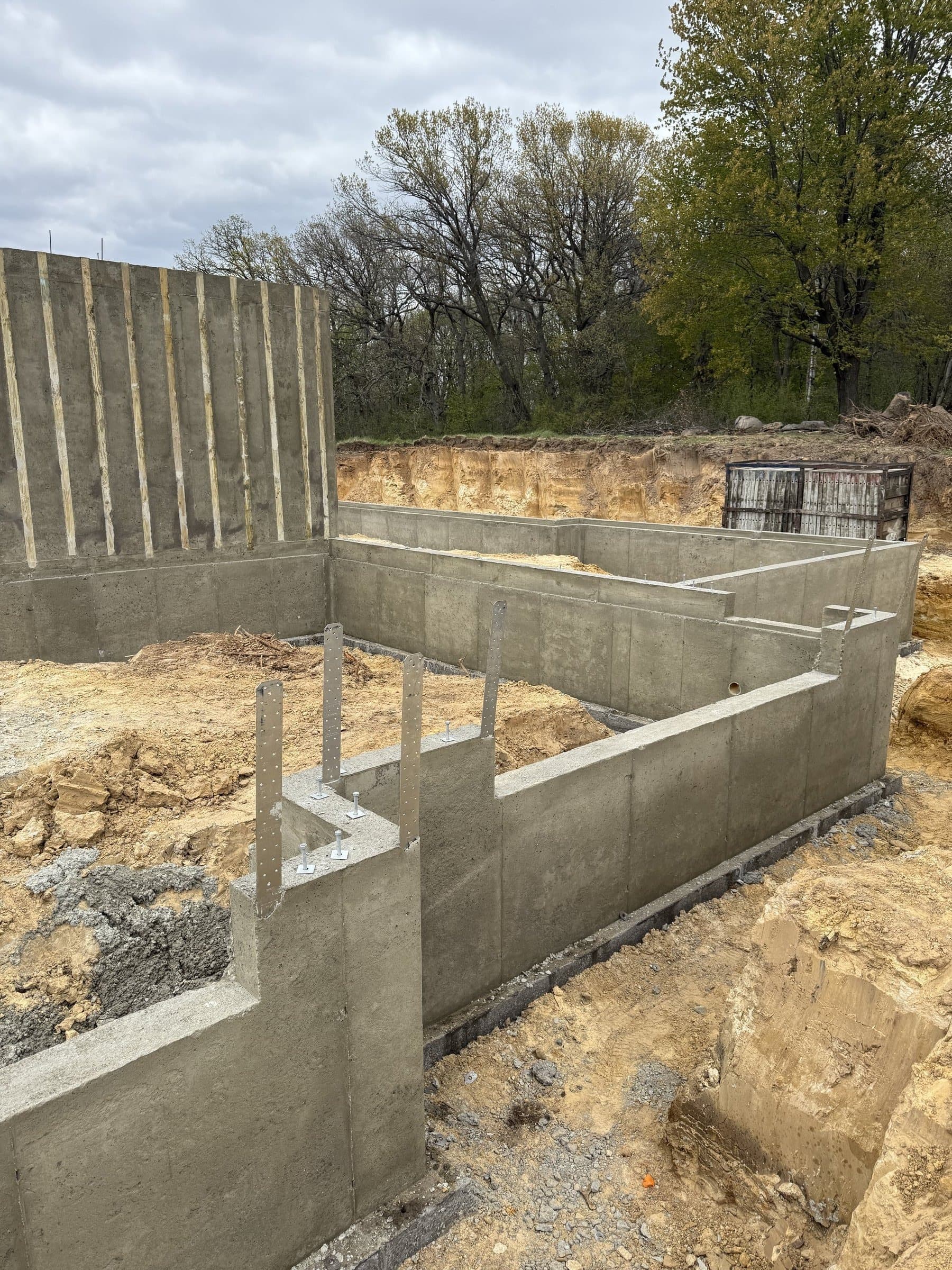

  14. Cured foundation walls at Oakridge with the forms removed.
    Week 3

    Foundation walls

    The foundation walls cured during the first full week of May. The house is designed for single-level living and is built slab-on-grade. A concrete safe room is included in place of a basement.

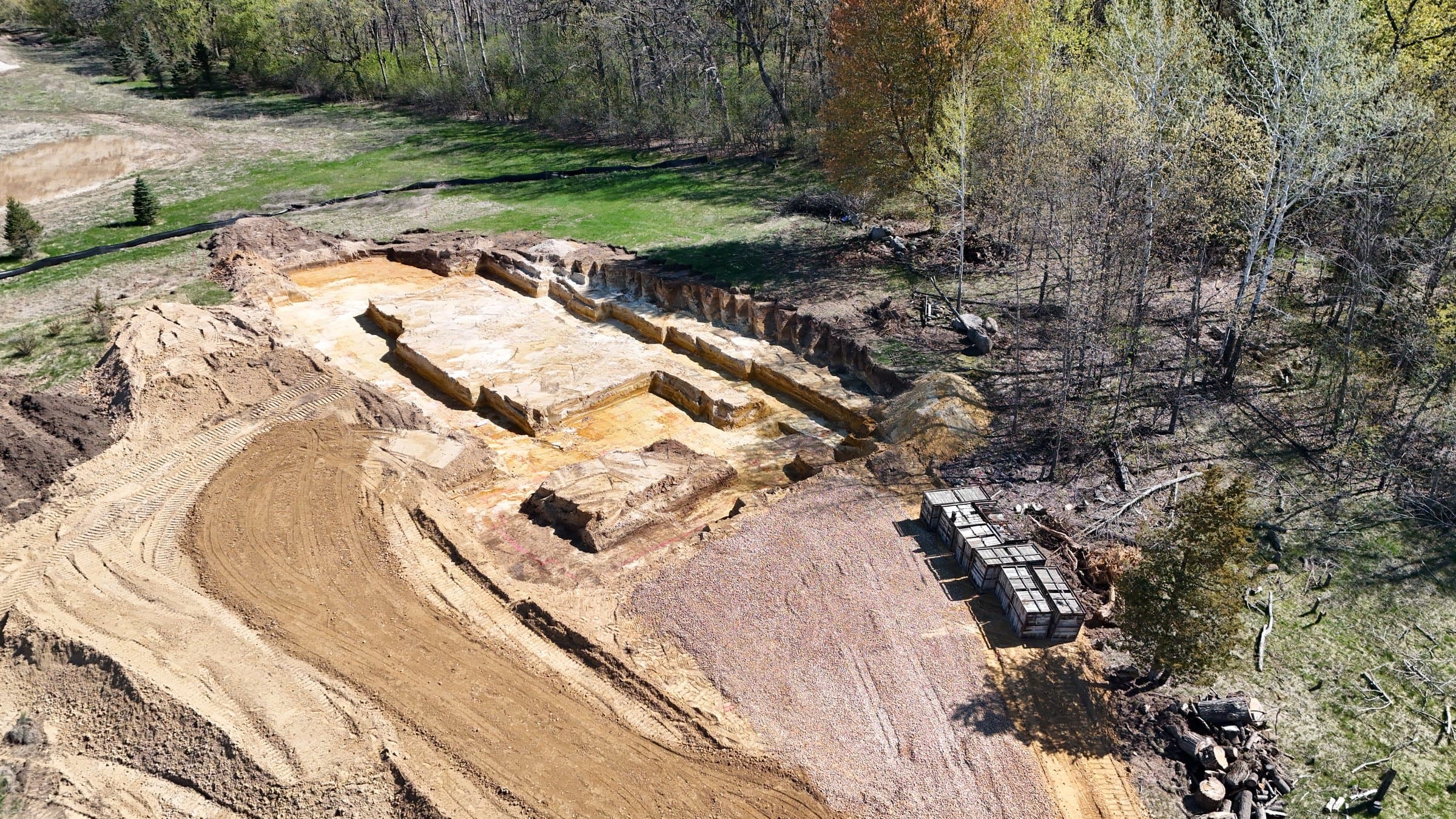

  15. Aerial view of the Oakridge foundation excavation with the footings trenched.
    Week 2

    Excavation and footings

    By the first of May, the building pad was graded and the footings were trenched. The driveway was cut in the same week. Materials for the foundation crew were delivered and staged on site.

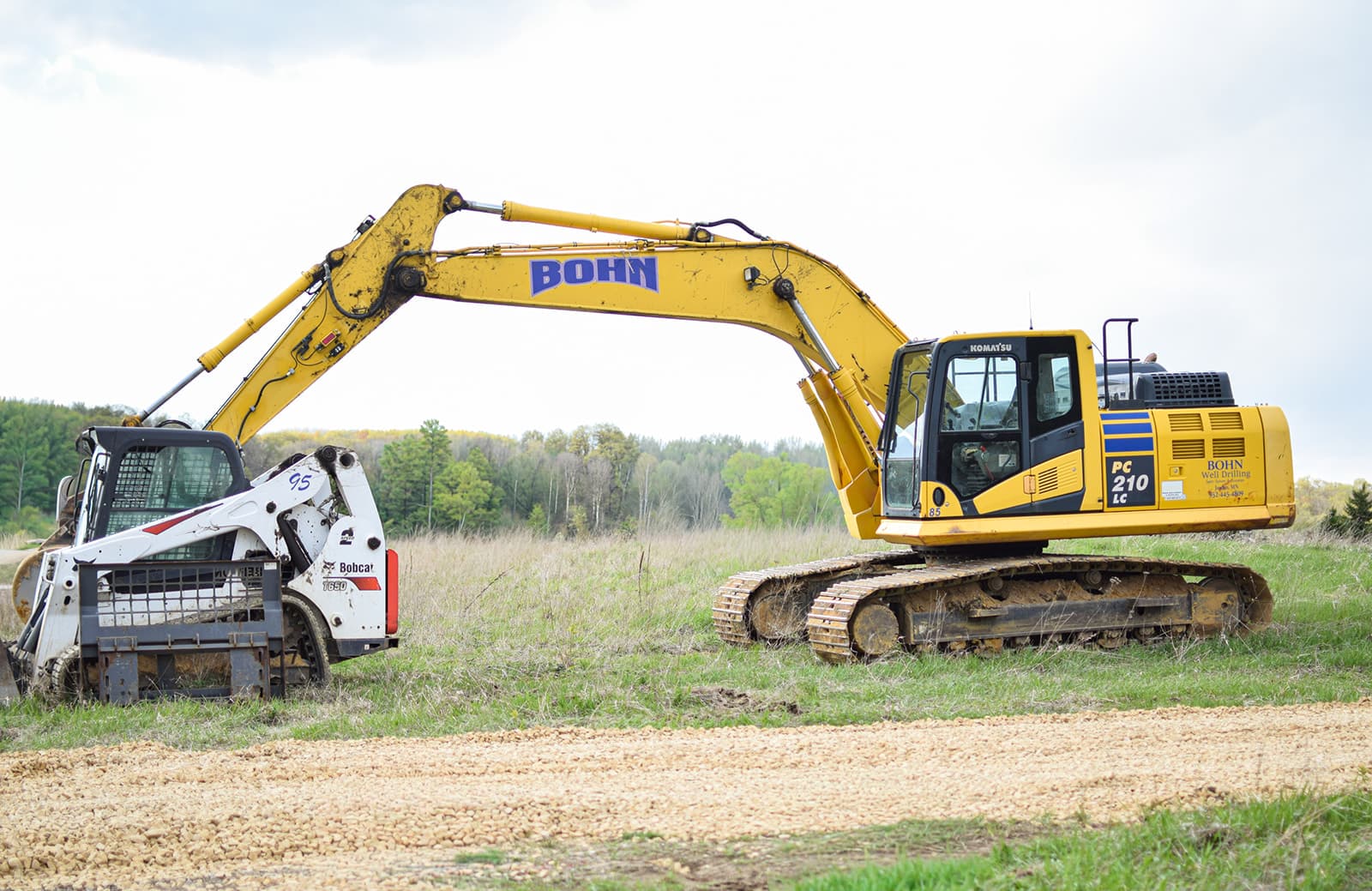

  16. An excavator and a skid steer staged on the Oakridge lot on the first day of construction.
    Week 1

    Groundbreaking

    Construction began in the last days of April 2026. The excavation crew arrived early in the day with an excavator and a skid steer. By the afternoon, the footprint of the house was visible from the access road. The site is five wooded acres at 5855 Oakridge Trail S in Afton.
